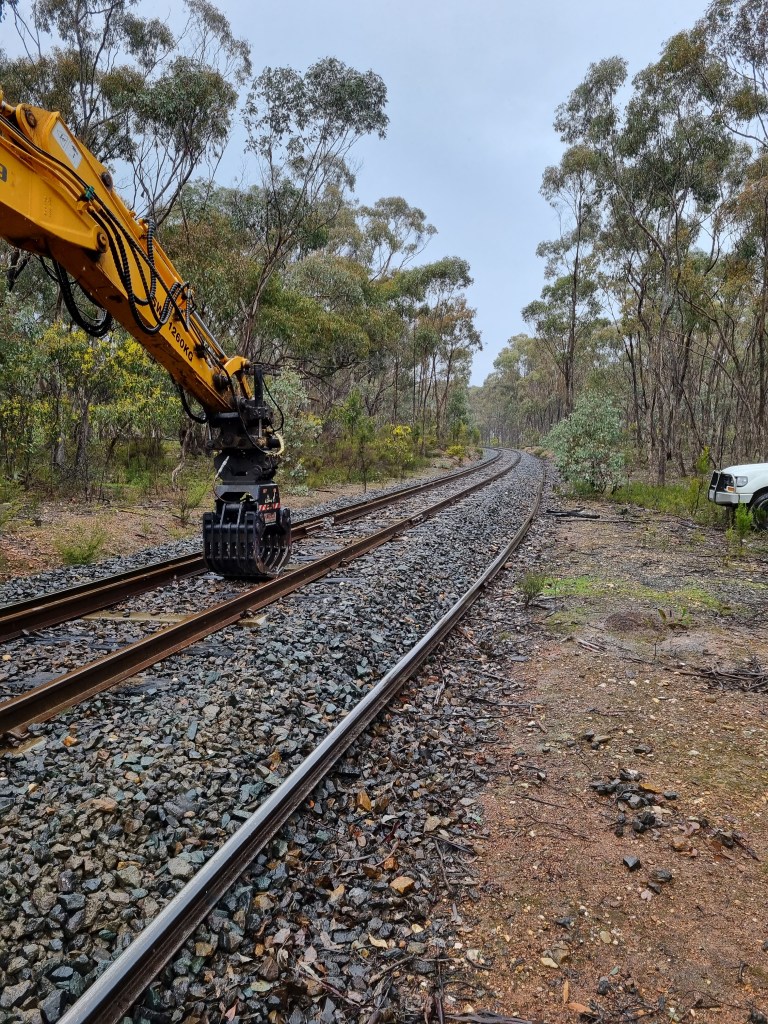

Despite the rain, we managed to install another 163m of rail today, into the high leg of Curve 9.

The difference in this section, with nothing more than the new rail is quite noticeable.

We’ve also distributed the jewellery right through the curve to speed things up next week.
Today’s effort takes us to just under half way around the high leg of the curve, meaning we should be able to get the whole curve completed next week.
This week’s rerailing total came to 617m, with the monthly total so far sitting at 1192m.
Tuesday’s gang will meet at Maldon at 8am or out on site from 8.30am.
