The past two days have been very productive, with all the pads installed on the 90 concrete sleepers trackside, all fastenings from Pyrenees Hwy to Winters Flat Bridge unfastened for the concrete sleeper treatment (it’s in anticipation for a delivery of more next week).

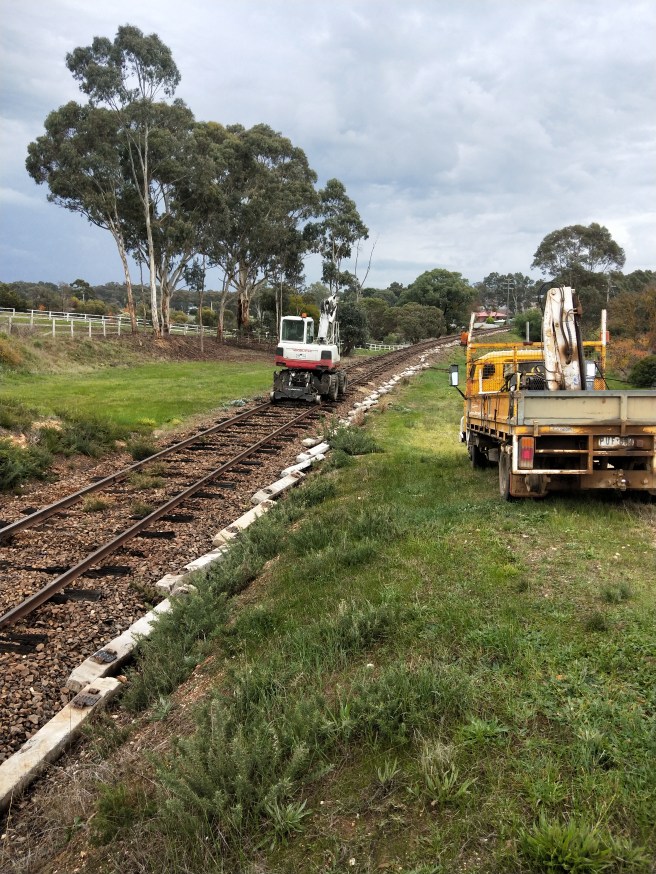

We have even managed to insert 81 of the sleepers in preparation for tomorrow’s clipping up. The other 9 are just waiting for the sleeper trenches to drain after filling in the storm last night.
Today also saw a full tamp and ballast scrape of everything unfinished on the down side of Pyrenees Hwy.
Tomorrow we’ll be meeting between the bridges around 8.30am to clip up the concretes before we move to Castlemaine to replace a few very tired point timbers.
